Project simplified schedule

Project simplified schedule

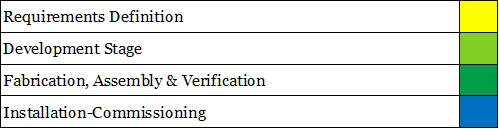

The HiLumi life cycle is divided into 4 main phases. The procurement of components is launched between 6 and 18 months before the “Fabrication, Assembly & Verification phase”. The time will depend on the cost of the procurement reaching up to 12 months for supplies which value is higher than 750 KCHF.
